The building is fast. The power gear is not.
What new equipment takes to arrive in 2026, and what you can do about it.
What new equipment takes in 2026.
| Equipment | Shortest | Longest |
|---|---|---|
| Generators (1 to 3 MW) | 72 | 104 |
| Substation transformers (5 to 25 MVA) | 65 | 95 |
| Power transformers (US market) | 52 | 78 |
| Chillers (Cooling plant) | 48 | 60 |
| Pad-mount transformers (Up to 5 MVA) | 40 | 65 |
| UPS systems (250 kVA to 2.5 MVA) | 30 | 40 |
Typical quoted lead times for new orders in 2026, compiled from industry reporting. Your quote depends on rating, specification and factory.

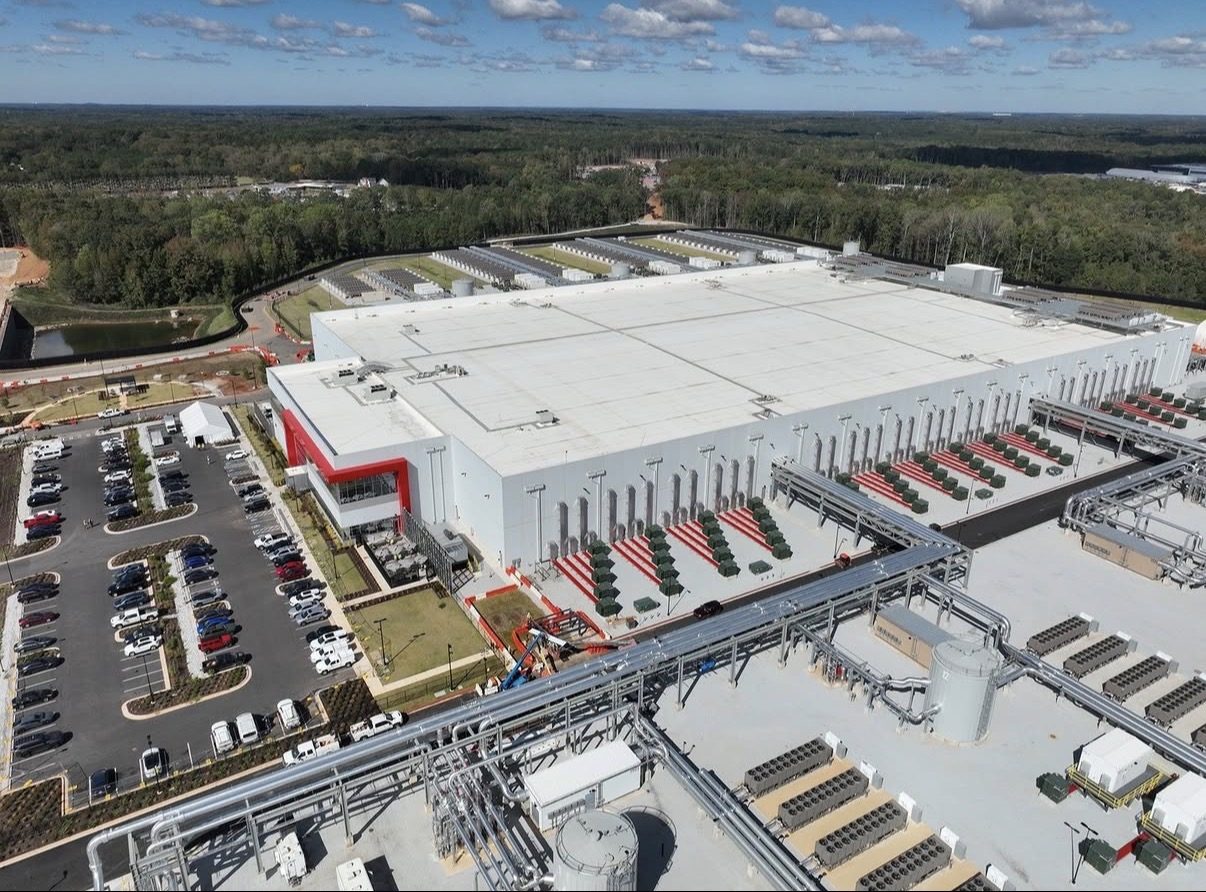

Campuses go up in months.
The shell, the roads and the racks move fast. The utility interconnect, transformers and switchgear behind them set the real energization date.

Generators are the longest wait on most sites.

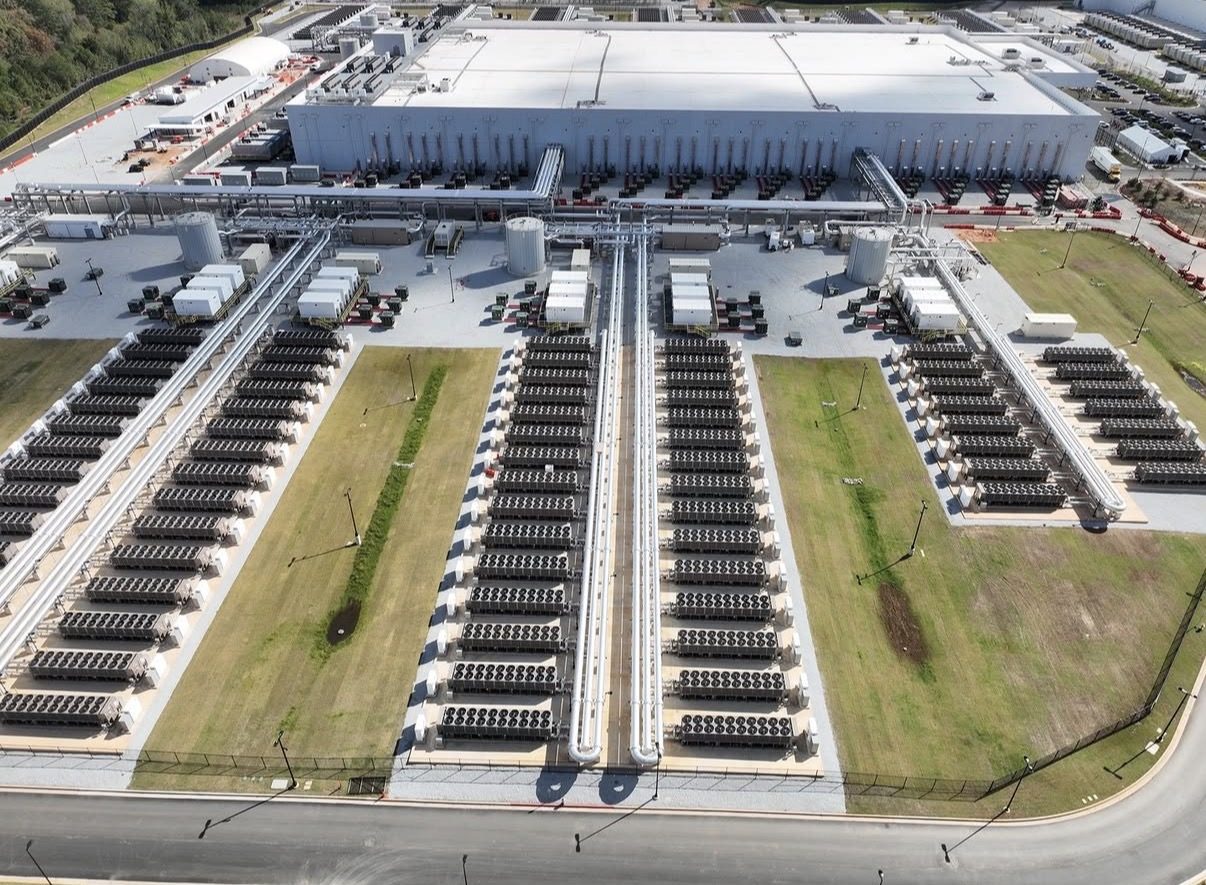

Standby power is usually ordered first and arrives last. It is the first thing we look for in surplus.
How to plan around the queue.
Order the long poles first. Generators and substation transformers set the date your site can energize. Lock them in before the rest of the electrical package.
Look beyond one factory. Quoted lead times describe a single queue. Plants in other countries often have open slots months earlier and build to the same ANSI/IEEE standards.
Price in surplus. Cancelled projects leave new, tested units sitting in yards. A unit that exists today can beat a cheaper one that arrives next year.
Get the paperwork moving early. Submittals and approvals often add weeks. We prepare them alongside the order so the factory never waits on a signature.
